Grid-Enhancing Technologies: The IEA Says 330 GW Is Already There

The International Energy Agency’s new report on grids makes an argument that is easy to state and hard to sell: the cheapest new transmission capacity is the capacity already sitting in the wires. Its analysis puts the prize from grid-enhancing technologies at up to 330 GW of extra generation, storage and demand that could connect to existing networks without building anything — in months rather than years.

Modernising Grids in the Age of Electricity, published on 21 September 2026, is the IEA’s attempt to quantify a category of equipment and software that utilities have piloted for years without adopting at scale. The subtitle sets the scope: “Scaling digital technologies and AI for better use of existing networks.”

The context is not in dispute. Electricity demand has grown at roughly twice the rate of overall energy demand over the past decade, and meeting its expected growth to 2035 requires grid capacity to rise by at least 30% — equivalent to adding or replacing 25 million kilometres of lines, three quarters of it in emerging market and developing economies. Meanwhile, at least 1,700 GW of advanced-stage renewable projects and 600 GW of utility-scale batteries were waiting for a connection in 2025, and congestion cost an estimated USD 12 billion in the United States and EUR 4.3 billion in the European Union in 2024.

190–330 GWThe IEA’s estimated range; 330 GW is the headline figure it uses
$100bnWhat connecting the same volume through network expansion would cost
1,700 GWAdvanced-stage renewable projects awaiting connection in 2025
23%Operators using AI in real-time operations, against 70% for maintenance

What the 330 GW Actually Consists Of

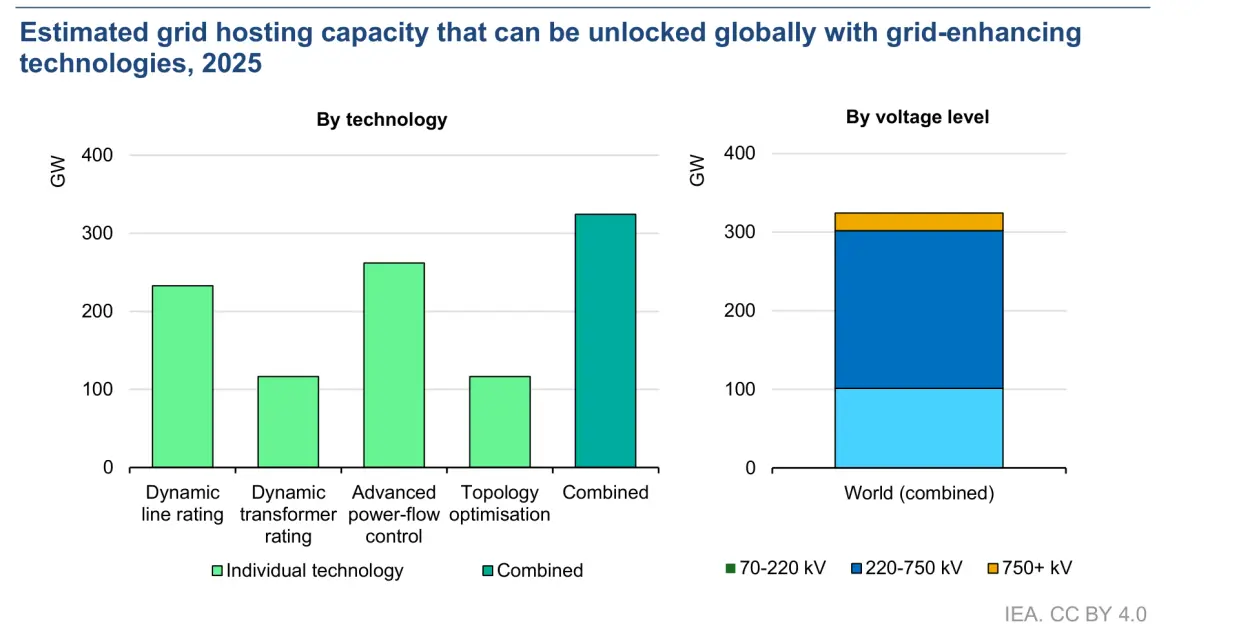

Chart: grid hosting capacity unlockable with grid-enhancing technologies in 2025, by technology and by voltage level
Source: IEA, Modernising Grids in the Age of Electricity (2026), CC BY 4.0 — reproduced under the report’s licence. The left panel shows each technology on its own: dynamic line rating and advanced power-flow control do most of the work, and the two transformer-side tools less. The right panel splits the combined figure by voltage level. The four individual bars add up to roughly 720 GW while the combined estimate is about 325 GW, because several of these tools can relieve the same constraint — which is why the IEA’s range cannot be read as a sum.

The figure covers the three technologies most widely deployed on transmission networks, and the IEA is careful to say other digital and grid-enhancing tools would add more.

TechnologyWhat it does
Dynamic ratingsAdjusts how much power lines and transformers can safely carry based on actual weather conditions, instead of a conservative static assumption
Topology optimisationReconfigures the network to route power around congested lines
Advanced power-flow controlPushes power onto underused paths

Three hundred and thirty gigawatts is roughly the combined installed generation capacity of France and Korea. The comparison the IEA offers is the cost one: connecting that volume through network expansion instead would require around USD 100 billion of investment. And it points out the obvious asymmetry in delivery times — most of these tools can be deployed in months, which means they relieve constraints while the steel is still being ordered.

One detail in the full report is worth carrying, because the headline hides it: 330 GW is the top of a range. The IEA’s estimate runs from 190 GW to 330 GW, reflecting different assumptions about how much extra capacity each technology delivers and how much of the network it can be deployed on with meaningful gains. The report states plainly that it uses “the upper end of that range as its headline figure”. On the IEA’s own modelling, then, 330 GW is the optimistic case, not the central one.

How the 330 GW Relates to the IEA’s Other Numbers

The report is a subset of earlier IEA work, and it says so. Its estimate is derived from the agency’s Electricity 2026 assessment, retaining only the technologies that fall within this report’s definition of grid-enhancing technologies. That earlier assessment found a combined global potential of 450–700 GW for a broader portfolio which also included storage as a transmission asset, reconductoring and voltage uprating. Restricting the scope to dynamic ratings, topology optimisation and advanced power-flow control produces the 190–330 GW figure.

A third category sits alongside both. Non-firm grid connections allow a generator, storage operator or large consumer earlier or larger access on the condition that output or consumption can be curtailed when the network is constrained. Electricity 2026 put that potential at 750–900 GW. Add the layers together — grid-enhancing technologies, physical upgrades and non-firm connections — and the IEA’s total is 1,200 to 1,600 GW of additional hosting capacity, against connection queues that now run into the thousands of gigawatts.

These are not substitutes, which is why the numbers do not simply add up in a headline. Grid-enhancing technologies increase how much power the network can safely carry; non-firm connections change when and how users may take it. In the report’s three-layer framework, the first sits in the network asset layer and the second in the flexibility layer — and the report analyses the first while leaving the second to other IEA work.

The Caveat the IEA Insists On: Some Congestion Is Efficient

This is the part of the report most summaries will skip, and it is the part that makes the rest credible.

The IEA states plainly that removing all congestion would mean sizing the grid for peak conditions at all times — and because wind, solar and many new loads run at full output only part of the time, such a network would sit well below capacity for most of the year. A degree of congestion is therefore efficient. Since network costs make up a substantial share of consumer bills, the question is not how to eliminate congestion but how to use what exists well enough that the remaining congestion is worth paying for.

That framing matters politically. Grid operators are routinely criticised for the size of their connection queues; the report’s response is that the queue is partly a pricing and risk-management problem, not only a construction shortfall. Operators hold margins below a network’s physical limits to cover risks they cannot fully observe, so better information lets those margins be narrowed safely. The same logic runs through the report’s treatment of AI: its value here is not autonomy but visibility — optimisation, forecasting, situational awareness and risk management, in the IEA’s phrasing.

The Evidence for Grid-Enhancing Technologies Is Already There

The report is not arguing from potential. It cites results already recorded in real networks: dynamic ratings producing around USD 64 million a year in avoided congestion costs in the United States; advanced power-flow control adding more than 2 GW of transfer capacity in Great Britain; and a digital twin — a detailed virtual model of the network — cutting the time needed to analyse reinforcement options by 70%.

Those are the kind of numbers that should travel. The IEA’s complaint is that they do not. Deployment remains highly uneven, and technologies proven at one site stall between pilot and standard practice, because each deployment has to justify itself from scratch in the absence of agreed methods for valuing the benefit or transferring the experience. Grid-enhancing technology deployment so far is concentrated in Europe and North America.

Why It Is Not Happening: People, Data, Trust, Rules

The report’s most useful data may be its survey of network operators on what is blocking them — and the answer is that almost nothing blocking them is technical.

Barrier identified by surveyed operatorsShare
Skills and organisational readiness64%
Availability and quality of data60%
Trust-related issues60%
Regulatory frameworks56%

The skills answer has a hard edge underneath it. Professionals who combine power-system and digital expertise are scarce, and the grid workforce is ageing: the number of workers aged 55 and over rose by nearly 50% between 2015 and 2024, against 20% for those under 55. Recruitment alone will not fix that; the report argues for changing workflows so that proven tools become part of routine operations rather than permanent pilots.

On regulation, the diagnosis is a bias toward concrete. Operators often have clearer routes to deploy new physical infrastructure than to deploy a digital or operational alternative that addresses the same need — funding rules that do not favour capital spending, incentives tied to measurable outcomes such as capacity unlocked and congestion avoided, and credible ways to value system-wide benefits. Regulatory sandboxes and innovation funding are suggested as routes to build the evidence. Better data and visibility are most urgently needed at distribution level, where rooftop solar, electric vehicles and heat pumps are being connected faster than operators can see them, and where information that does exist often sits in incompatible formats across organisational silos.

The AI Paradox in the Report

AI appears twice in this story, and the two appearances pull in opposite directions.

First as demand: the data centres behind AI are a fast-growing load that can worsen the congestion the report is trying to relieve — the same pressure visible in the grid equipment being ordered for AI campuses. Then as tool: applied to energy systems, AI offers improvements in forecasting, inspection, maintenance and planning.

The IEA’s own figures show how far apart the two applications sit in practice. Among surveyed operators, 70% use AI widely for maintenance, but only 23% use it in real-time operations. The reason given is not capability but accountability: when AI informs safety-critical decisions, explainability, auditability and accountability requirements bind, and the operator remains responsible for the outcome. Planning and asset-management applications are described as relatively mature; operational control is where adoption stops.

What the Report Does Not Settle

Three limits are worth stating, because the 330 GW figure will travel further than its footnotes.

The capacity is bounded and variable. The IEA says outright that the capacity these tools release is limited by the physical network and changes with weather and system conditions, so they cannot deliver the step change that demand growth requires. Where conditions are favourable they can defer or avoid individual reinforcements — that is the claim, and it is narrower than “330 GW of new grid”. The model behind the number covers high-voltage networks of 70 kV and above as of 2025 and deliberately excludes system-specific constraints: voltage limits, fault levels, substation capacity and local generation-load patterns, all of which the IEA says require detailed network studies. It is a technical potential, not a connection offer.

Storage and demand-side flexibility are elsewhere. Both are routes to higher network utilisation, but the report treats them as complementary topics covered in other IEA work, with non-firm connections placed in a separate “flexibility layer” of its three-layer framework and analysed in other IEA publications. This document — which leaves the demand side, including vehicle-to-grid and megawatt-scale charging loads such as flash-charging networks, outside this document.

No technology-by-technology cost curve. The USD 100 billion figure is produced by converting the estimated hosting capacity into an equivalent length of avoided transmission line and pricing it against representative unit construction costs. The report does not publish a cost per gigawatt for each technology, nor a deployment timeline for any of them. For an investor or a regulator deciding what to fund first, that is the missing table.

AI gets no number of its own. The report is explicit that AI can improve how grid-enhancing technologies are targeted and operated — sharper forecasting, faster screening, better remedial-action analysis — but that its contribution cannot be estimated separately, and that this analysis “does not quantify a separate AI uplift”. The 330 GW, or rather the 190–330 GW, is a figure for the hardware and control technologies, not for the intelligence applied to them.

Author’s Take: The interesting finding here is not that software can squeeze more out of power lines — utilities have known that for a decade. It is that 64% of surveyed operators name skills and organisational readiness as the main obstacle, and that the 55-and-over share of the workforce has grown about 50% in nine years. Grid constraints are usually discussed as a copper-and-transformer problem; the IEA is quietly saying they are also a staffing and process problem, and that the cheapest capacity on offer requires people who understand both a substation and a data pipeline. The 23% real-time AI figure points the same way: the tools work, the accountability structure around them does not yet. Watch whether any regulator actually rewrites funding rules to stop favouring concrete over code — that, not the 330 GW, is the variable that decides how much of this gets used.
The Bottom Line: The IEA estimates that dynamic ratings, topology optimisation and advanced power-flow control could connect up to 330 GW of new generation, storage and demand to existing networks without reinforcement — volume that would otherwise cost around USD 100 billion in new lines — while acknowledging that some congestion is efficient and that these tools cannot substitute for expansion. The blockers it identifies are institutional: skills, data quality, trust and regulatory bias toward physical construction, with only 23% of operators using AI in real-time operations against 70% for maintenance. Three things to watch: whether regulators change cost-recovery rules to fund software as readily as steel, whether the workforce gap is addressed before the retirement wave lands, and whether the proven results in the US and Great Britain get replicated anywhere outside Europe and North America.

Sources & Further Reading

Accuracy note: All figures, quotations and characterisations of the IEA’s position in this article are taken from the report itself, which we read in full, including the Chapter 3 methodology and its assumptions. The IEA’s estimate for grid-enhancing technologies runs from 190 GW to 330 GW and the report states that it uses the upper end as its headline; we quote 330 GW because that is the IEA’s own headline figure, and the range is disclosed above. We have not re-run the model or verified its network data, so the number remains an IEA calculation, and the 1,200–1,600 GW total and the 450–700 GW and 750–900 GW components originate in the separate Electricity 2026 assessment, which we have not read in full. The technology descriptions in our table paraphrase the IEA’s wording. The survey percentages, the workforce data and the 70% / 23% split on AI use are the IEA’s, drawn from its survey of network operators; we have not seen the underlying questionnaire or sample. The 2,500 GW connection-queue figure belongs to a different IEA publication, “Electricity 2026”, and is labelled as such in the text. Where we describe a limitation — the absence of a cost per gigawatt, or the treatment of storage and flexibility as out of scope — that is our reading of the document, not a statement by the IEA.

Sourcing note: The primary source is the IEA’s report and its executive summary, read directly. No other outlet’s framing was used for the substance. The analysis and the selection of which findings to foreground are EVsays’ own; the report is published under a CC BY 4.0 licence. Our standards are set out in our editorial policy and errors are handled under our correction policy. Images: the chart is reproduced from the IEA report under its CC BY 4.0 licence.

SHENG HE
SHENG HE

Sheng He is the founding editor of EVsays. He launched the site as an electric-vehicle news desk and has since expanded its remit to the broader electrification transition — batteries, storage, charging, robotics and clean power.
He spent eight years in automotive sales at the dealership level, working with multiple major brands — experience that gave him a front-line read on what buyers actually ask, fear and choose. That ground-level perspective now anchors the site's coverage of cars, batteries and the wider electrification shift.
He writes original, source-backed reporting for an international readership, with a reporter's instinct for separating confirmed fact from rumor.

Articles: 148

Leave a Reply

Your email address will not be published. Required fields are marked *
